An official website of the Republic of AinareAccessibilityEN
06

PUBLIC ACCOUNTABILITY · Q2 2026

Safety and Mission Assurance Summary

The quarterly public summary of significant safety findings, independent assessments, corrective actions and mission-readiness assurance activity.

ANSA-SMA-Q2-2026 · PUBLISHED 8 JULY 2026

The quarterly public summary of significant safety findings, independent assessments, corrective actions and mission-readiness assurance activity.

Security-sensitive and personally identifying information is excluded. Redactions are listed by statutory authority.

Request an accessible copyAll agency reports

DOCUMENT REPRODUCTION

Selected pages from the filed edition

Reference reproductions from the authoritative public record. Paper tone, handling marks, audit notation and authorized redactions are retained where present.

Scanned public-edition cover of the ANSA Safety and Mission Assurance Summary for Q2 2026.
PUBLIC COVER

Quarterly public summary filed under ANSA-SMA-Q2-2026.

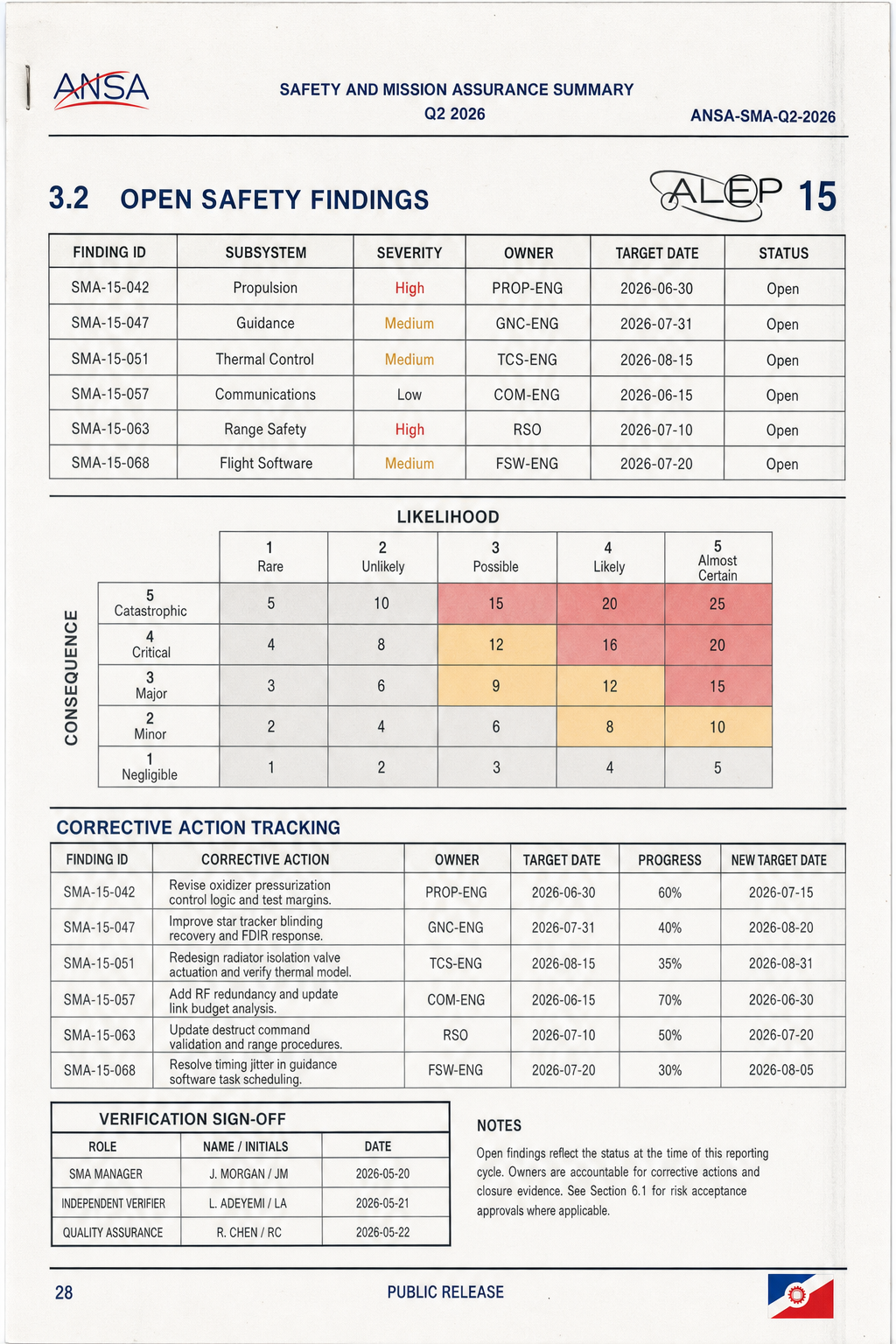

Scanned ANSA safety report page showing open ALEP 15 findings, a risk matrix and corrective-action tracking.
PAGE 028

Open safety findings, risk classification and corrective-action tracking.

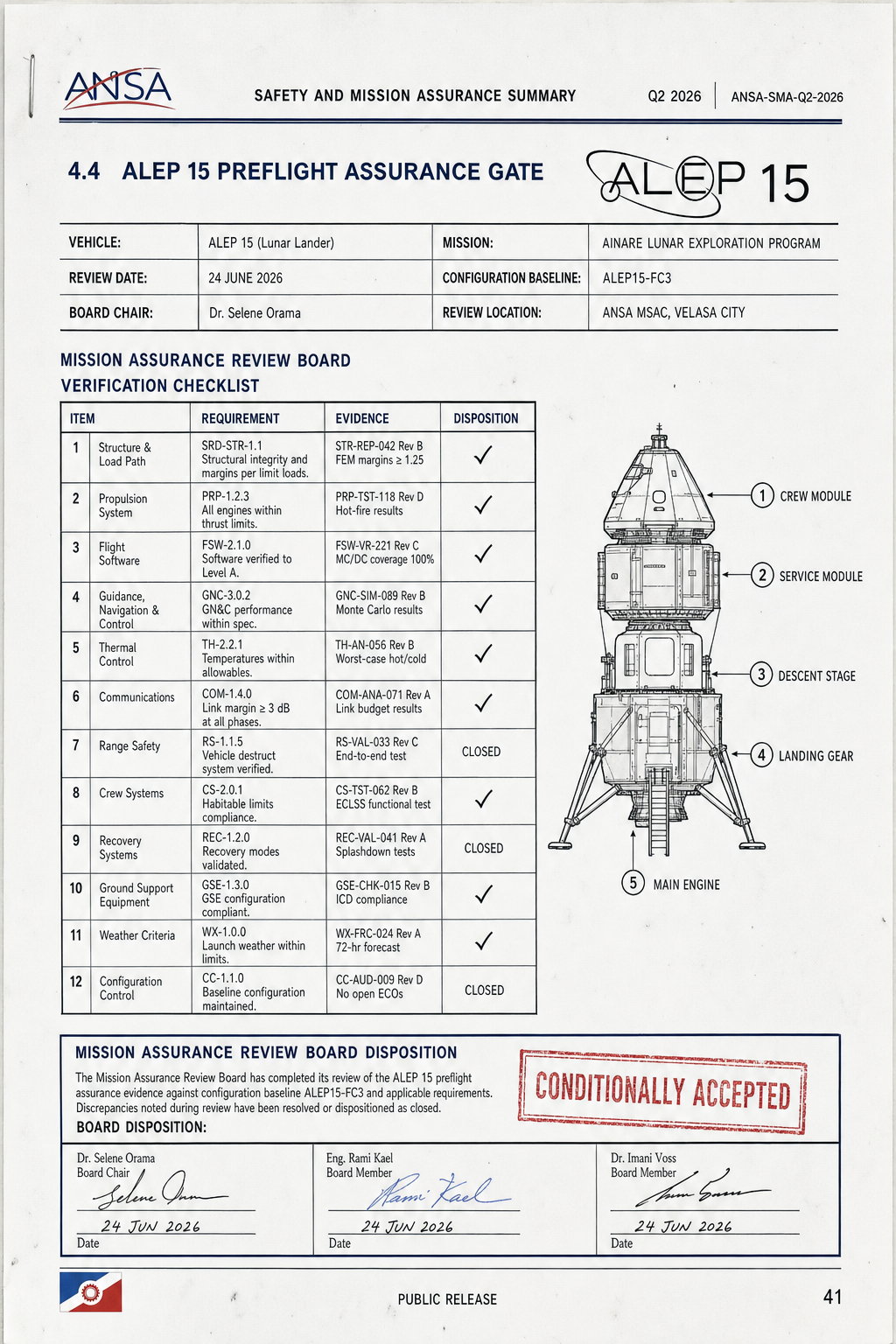

Scanned ANSA safety report page showing the ALEP 15 preflight assurance gate checklist and review-board signatures.
PAGE 041

ALEP 15 preflight assurance gate and signed review-board disposition.

ARCHIVE CONTROLANSA-SMA-Q2-2026

Page references follow the pagination of the filed public edition. Reproductions are supplied for visual reference; the publication record above remains controlling.

REPORT SUMMARY

Principal findings

Selected statements from the public report; consult the authoritative edition for scope and methodology.

FINDING 0101

No agency Class I mishap occurred during the reporting period.

Reported under ANSA-SMA-Q2-2026.

FINDING 0202

ALEP 15 closed 31 of 34 preflight independent-assessment actions.

Reported under ANSA-SMA-Q2-2026.

FINDING 0303

Three remaining actions are scheduled for closure before the Flight Readiness Review.

Reported under ANSA-SMA-Q2-2026.

FINDING 0404

Supplier quality surveillance increased for cryogenic-valve and avionics lots.

Reported under ANSA-SMA-Q2-2026.

CONTENTS

Report structure

Major sections in the authoritative public edition.

01CHAPTER

Mishap and close-call reporting

Agency occurrence statistics and corrective-action status.

02CHAPTER

Mission assurance

Independent reviews for ALEP, science missions and flight research.

03CHAPTER

Institutional safety

Range, laboratory, aviation and occupational safety performance.

04CHAPTER

Corrective-action register

Publicly releasable action owners, milestones and closure evidence.
